Financials

What is a budget?

A Budget in Operating is the agreed monetary value of an engagement — the financial target a project is planned and measured against.

Written By Lauri Eurén

Last updated About 17 hours ago

A Budget in Operating is a monetary amount assigned to a Project for a date range. It's usually the value you've agreed with the client in the contract or statement of work.

The Budget is the financial target the Project is planned and measured against. What it does depends on the billing type:

  • Fixed-price and capped time-and-materials: it sets or caps the revenue.

  • Retainer: each Budget is the fee for one retainer period.

  • Time-and-materials: it's an optional target.

Some Projects have no Budget at all.

Operating has a few related financial pieces that are easy to confuse — a Budget, planned Allocations, planned Expenses, and actuals. This article explains what a Budget is and how they fit together.

What a Budget covers

For planning, you can split a Budget into two sides:

  • Expense budgets: one amount per expense category, such as travel or software. Together they can't be more than the Budget.

  • Allocation budget: the labor side, which is whatever the expense budgets leave.

Expense budgets are planning guidelines. They make burndowns and forecasts more accurate, but they don't block spending or change revenue recognition. To set them, see How to add expenses and expense budgets.

A Project can have one Budget or several — for example, a follow-on extension or a contract amendment — each with its own amount and date range. Budgets may not overlap in time.

A new Budget gets a numbered name, such as Budget 2, that no other Budget of the Project has. You can change the name in the Budget dialog.

On a retainer Project, the retainer settings create one Budget for each retainer period, so you don't add those Budgets one by one. See How to set up a retainer project.

Budget vs. plan vs. actuals

This is the distinction worth getting straight:

  • The Budget is the target — the agreed value of the engagement.

  • The plan is how you intend to deliver it: planned Allocations (the people and their effort) and planned Expenses (the non-labor costs). On time-and-materials work, the plan is also how you expect to reach the Budget. On fixed-price, it's your cost of delivering a price that's already fixed.

  • The actuals are what really happened: tracked Time entries and recorded Expenses.

Comparing the plan and the actuals against the Budget is exactly what the planned-vs-actuals view and the burnup chart show — see Understanding planned vs. actuals.

Budget targets

A Budget can also carry targets. A target is an internal figure for the hours, the cost, the margin or the hourly rate you plan the work to. Targets don't change invoicing or revenue.

A target covers the whole Budget, or one role, seniority, person or task. Margin and hourly rate targets are only for fixed-price Budgets and for retainer periods that don't invoice overage.

For how Operating measures targets and who sees them, see How budget targets work. To add one, see How to set targets on a Budget.

The Budget card on the timeline

On the project timeline, hover over a Budget's bar to see its card, or click the bar to keep the card open. The card shows the Budget's name, its dates and amount, and a ring for the Budget's work. Click the Edit icon to change the Budget, if you have the right to edit it.

What the ring shows depends on the Budget's dates:

  • The Budget has ended: the ring shows the tracked work. A thinner ring inside it shows the planned work.

  • The Budget is in progress: the ring shows the forecast. A thinner ring inside it shows the work tracked so far.

  • The Budget hasn't started: the ring shows the planned work.

The forecast is the work tracked up to the forecast cutoff date, plus the work planned after it. The lines next to the ring give the same figures. The Budget's bar shows the same work as a share of the Budget.

On a Project with a Tentative status, the Budget's plan counts tentative allocations as well as confirmed ones. A tentative allocation counts at its full hours, time value and cost. Its allocation probability does not reduce it. On a Project with any other status, the plan counts confirmed allocations only.

The bar gets an orange stripe along its bottom edge when the forecast goes past the Budget's amount, its cap or its target for the whole Budget. The card also adds a line in these cases:

  • The forecast goes past the amount: on a Budget without a target for the whole Budget, the card shows, for example, €2,000 over the budget. On a Budget capped by amount, it reads €2,000 over the cap.

  • The hours go past an hour cap: the card shows, for example, 5h out of budget scope. Nobody pays for those hours.

  • Some of the work is non-billable: the card shows, for example, 4h non-billable.

On a Budget capped by hours, the ring counts the billable hours against the cap, and the caption under the ring reads, for example, "of 40h cap". The Budget's bar reads, for example, "75% of 40h budget (Budget 1)".

On a Budget with a target for the whole Budget, the ring and the bar measure the work against that target, and the card lists the Budget's targets. See How budget targets work.

On a retainer Project, each retainer period has its own bar. Its card shows the period's fee and included hours, the planned and tracked hours, and an Edit period button.

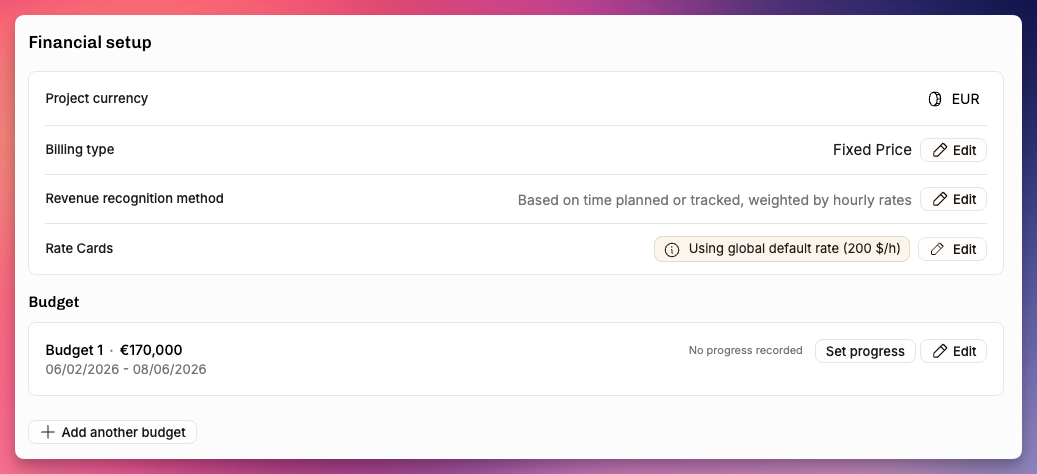

The budget card on the timeline.

Split a Budget

A Budget can be divided into two Budgets at a date, for example when a contract changes partway through the engagement. Each of the two Budgets then has its own dates and amount. See How to split a Budget. A retainer period can't be split.

Delete a Budget

To delete a Budget, open its dialog, open the ⋯ (More actions) menu and choose Delete budget. On a retainer Project, the menu item reads Delete period. Operating asks you to confirm before it deletes the Budget.

How the Budget anchors revenue

What the Budget does depends on the billing type:

  • Fixed-price: the Budget is the agreed price. It's what you invoice, however many hours the work takes.

    • Revenue follows the recognition method. The method spreads recognized revenue against the Budget over time. A manual budget progress entry can drive it when completion doesn't follow hours. On When a milestone is completed, completed milestones drive it, and their amounts can't add up to more than the Budget.

    • Hours don't add revenue. Deliver in fewer hours and you keep more margin. Spend more hours and your effective hourly rate and margin drop.

    • Keep the work inside the Budget's dates. Work outside every Budget's date range adds cost but no recognized revenue. Extend the date range so it covers all allocated and tracked work.

    • Outside budget dates warning. On every method except evenly by month and evenly by week, the Overview, Timeline and Status tabs warn you about work outside every Budget's dates. The warning lists the time entries, allocations, expenses and planned expenses involved, with their cost or value. If you can't see costs or revenue, it shows only the hours and the number of items. The Revenue recognition tab shows a similar warning.

  • Capped time-and-materials: the Budget is a hard cap — you bill actual work up to it, and nothing beyond. In Cap by, you choose what the Budget caps:

    • Amount: the Budget's amount is the most revenue the work can earn. This is the default.

    • Hours: Cap is the number of billable hours the Budget covers, whatever their rates. Hours tracked past the cap earn nothing. A Budget capped by hours has no amount.

    • If the forecasted work is worth more than the Budget, the Project’s Overview, Timeline and Status tabs show a warning with the amount of work outside of budget scope. On a tentative Project, the warning compares planned work with the Budget.

    • On a Budget capped by hours, the warning counts hours instead, for example "5:00 h of tracked work is past the hour cap and earns nothing."

  • Time and materials: the Budget is a target to aim for. You invoice actual time, so more billable work earns more. If the work runs past the Budget, that's the cue to agree an extension with the client rather than leave revenue uncaptured. The Budget's amount is optional, so a Budget can plan the work with targets alone.

  • Retainer: each retainer period is a Budget, and its amount is the fee for that period. The fee is earned across the period whether or not anyone tracks time. Hours past the period's included hours bill as overage on top of the fee. See How retainers work in Operating.

  • Non-billable: there's no client revenue. A non-billable Project can still have Budgets to plan the work against. Their amount is optional, and they take hours and cost targets. You can compare the planned vs. actual hours in the Projects Reports (see more in Reports available in Operating).

  • Switching billing type. Fixed-price and capped time-and-materials Budgets need an amount. Give every Budget an amount before you switch the Project to one of those billing types.

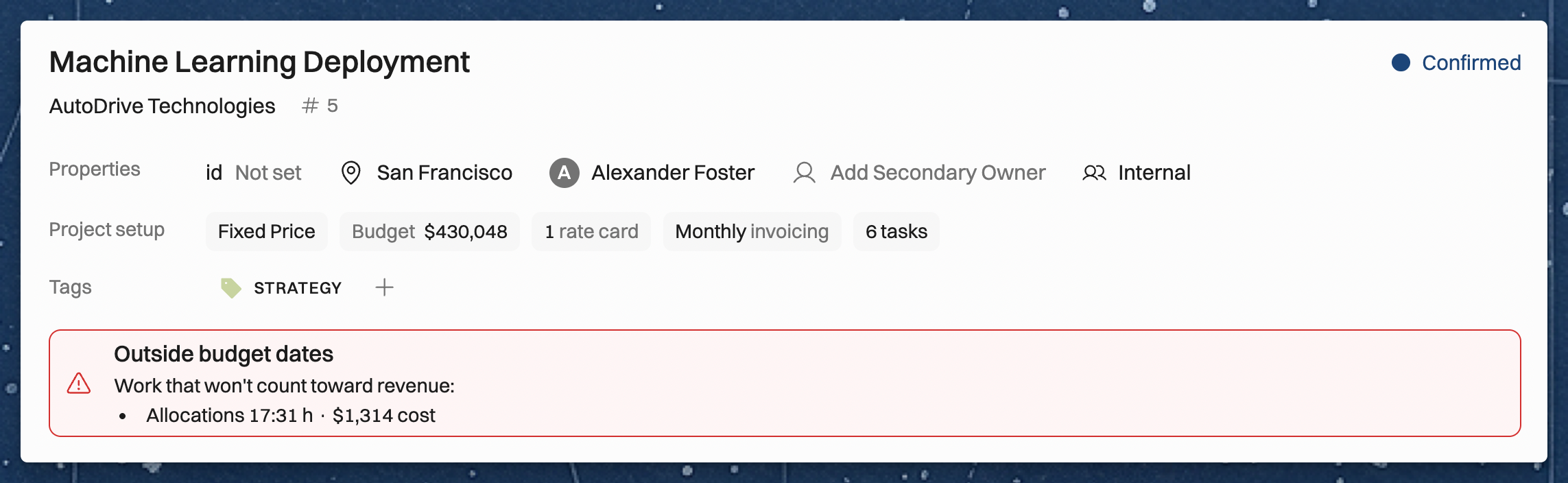

Work outside budget dates warning in the project details page.

For how those billing types read profitability and margin, see Budgeting and profitability: a worked example. For the recognition methods, see How revenue recognition works in Operating .

Budgets with milestone amounts

On a fixed-price Project, milestones can carry a revenue recognizable amount and an invoice amount. Each such milestone sits on the Budget that covers its target date, and that Budget follows these rules:

  • The amounts fit the Budget. The milestones' revenue recognizable amounts can't add up to more than the Budget, and neither can their invoice amounts. The Budget amount also can't go below what its completed milestones have recognized.

  • The dates keep covering the milestones. You can't change the Budget's dates so that a milestone with an amount falls outside them. Move the milestone first.

  • No delete or split. You can't delete or split the Budget while milestones carry amounts on it. Move the milestones to another Budget's dates, or clear their amounts, first.

See Milestone-based revenue recognition and invoicing.

Budgets with budget progress

A Budget's dates must keep containing its budget progress entries:

  • The start date is fixed. You can't change the Budget's start date while it has a budget progress entry.

  • The end date can move. You can change the end date as long as every budget progress entry stays inside the new dates.

The same rules apply when you drag or resize the Budget's bar on the timeline. In the date picker, the dates you can't choose are greyed out. Operating refuses a change that breaks these rules, and it never deletes a budget progress entry to make the dates fit. For the dates an entry itself can have, see How Operating calculates earned and forecasted revenue.
